Juristic, part of Board IntelligenceHelp centre
Browse guides

Give each workstream its own view

Saved views per workstream with their own groups, columns and filters, and who can open them.

Screenshots are taken from the app on every release. Updated 16 November 2026.

On a deal, due diligence, disclosure, financing and signing run side by side on one board. The associate on disclosure does not need forty financing items in the way, and the partner wants the closing items with only the columns that matter. A view per workstream gives each of them the board they need, while every task stays on the one board.

Two questions decide how you set each view up. Which part of the deal is it for? That decides its task groups and columns. Who should open it? That decides its access.

Adding and editing views is for the board's managers: people in the firm who are not limited to a permission set.

Add the view

  1. Click + beside the view tabs at the top of the board (Add view).

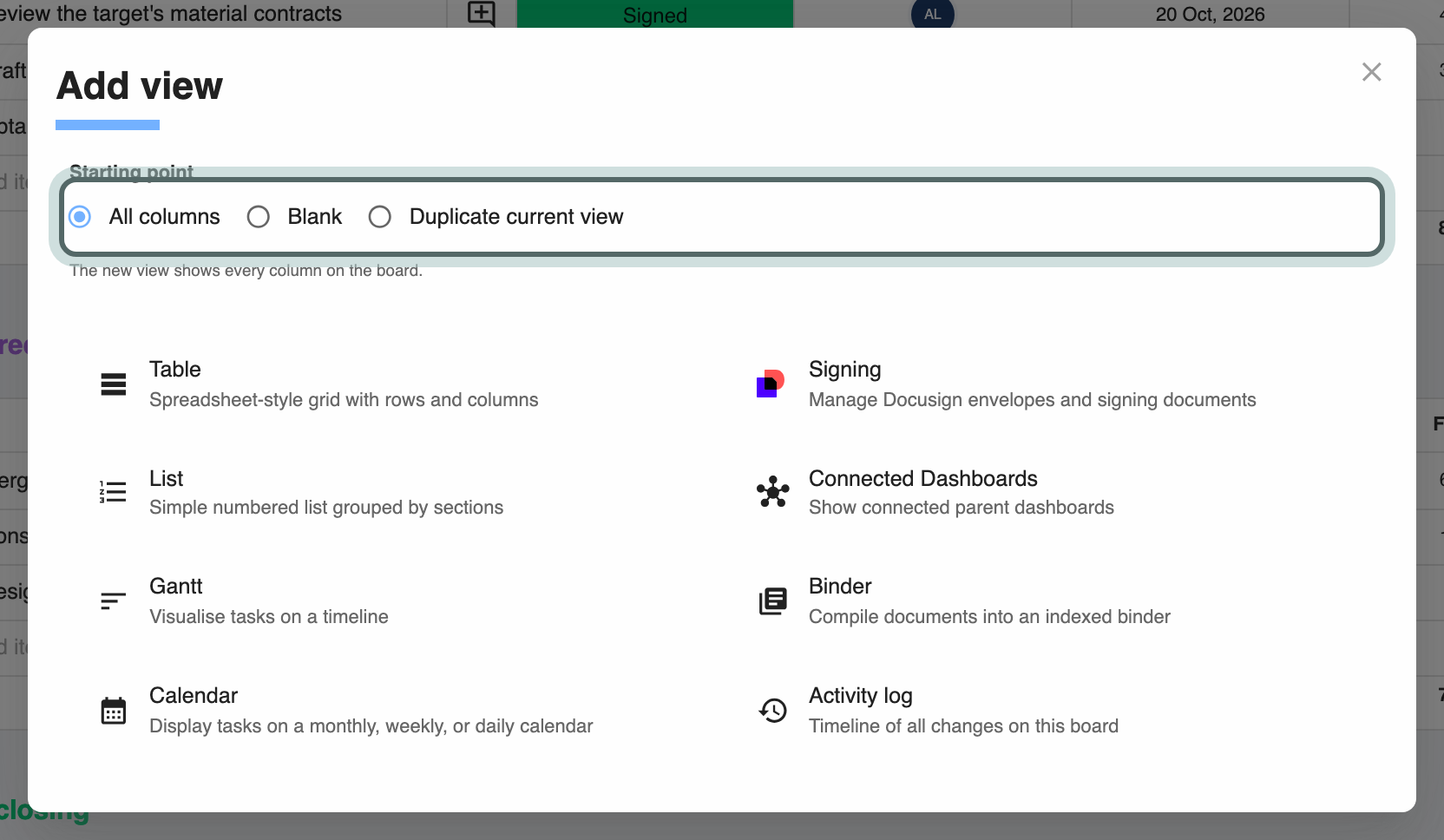

  2. Under Starting point, choose what the view begins with. All columns shows every column on the board. Blank starts with the board's added columns hidden, so you pick only what this workstream needs; the task names stay visible. Duplicate current view copies the view you are on, with its columns, groups, filters and access, which is the quickest way to make a second view like one that already works. The starting point applies to Table, List, Gantt and Calendar views.

  3. Choose the type.

The workstream needs Choose
The full checklist to work in, with all its columns Table
A short numbered list to read through, grouped by section List
The timetable, with tasks as bars between dates Gantt
Deadlines by month, week or day Calendar
DocuSign envelopes and the signing documents Signing
The documents compiled into an indexed binder Binder
A record of every change on the board Activity log

Gantt and Calendar ask which date column to use, or create one. They and Binder let you give the view a Title before you click Create. A board has one Signing view at most. On a board with more than 200 tasks, new views cannot be added.

  1. Name the view after the workstream: right-click its tab, choose Rename, and type "Disclosure" or "Financing". Views of the same type share one tab; click it to choose between them.

Show only that workstream

  1. With the view open, click Board and choose Edit views. The dialog lists the board's views on the left, grouped by type; the one you are editing is on the right. Double-click a view's name there to rename it, or drag it to change its place in the view bar.

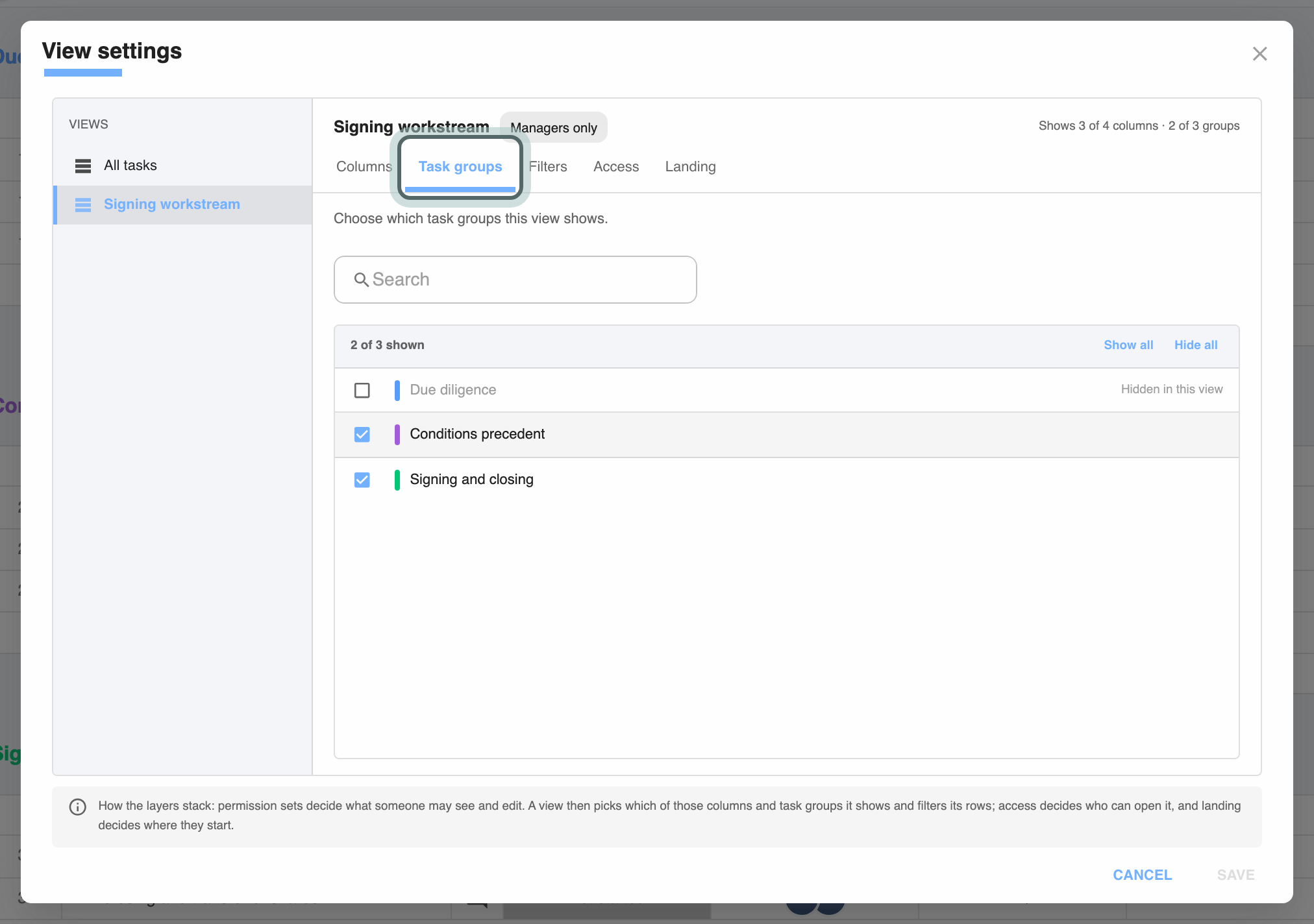

  2. On Task groups, tick the groups this workstream covers and untick the rest.

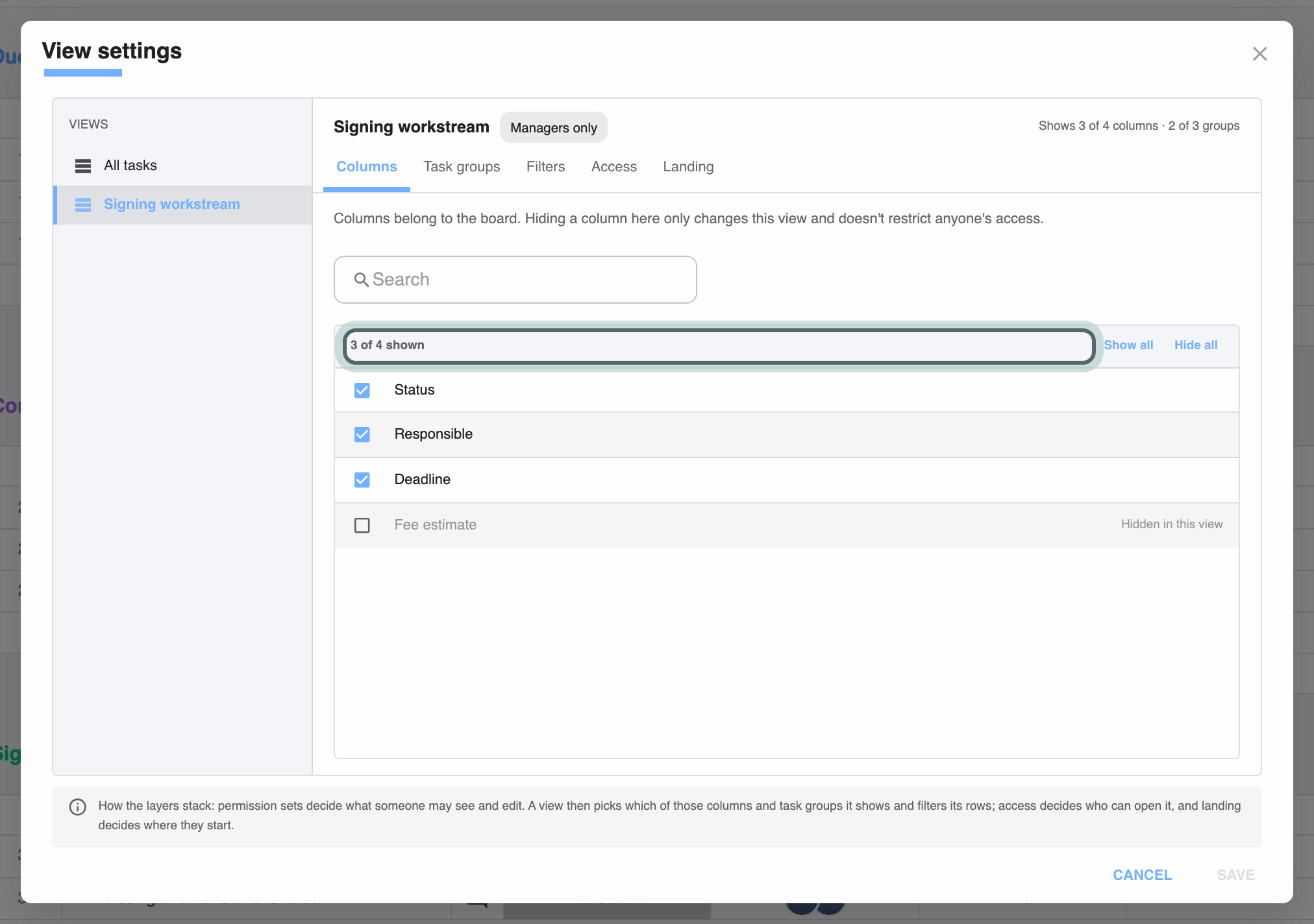

  3. On Columns, hide what this workstream does not need. The count shows how many of the board's columns are shown. A blank view opens here directly.

  4. On a table view's Columns tab, turn off Summary row if the workstream needs a short checklist without totals beneath each task group. Leave it on for a status call where the group summaries help. Click Save to keep the choice for this view; the board's other views keep their own setting.

    Summary rows appear only while Show all tasks (no scroll) is on in Board settings, even if Summary row is on for the view.

  5. On a table view, Filters narrows the rows further, for example to tasks not yet done. Filters apply to everyone who opens the view and are saved as you edit them.

Put the columns in reading order

For a status call, put the status and responsible person before the task name. For a short signing checklist, leave out the row numbers if nobody needs to refer to them.

  1. Click Board and choose Table views & columns. You can also open it with Choose and order columns on a table view's Columns tab in Edit views.

  2. Choose the table view on the left. Column order lists what it shows, from left to right; Available columns holds what it hides. A view you have not reordered starts with ID, the row numbers, then Item, the task names, unless columns were already pinned before Item on the board.

  3. Drag Item within Column order, or select it and use the up and down arrows. Move it below Status and Responsible when those are the first things you read on a call. Move ID the same way if the numbers belong elsewhere. Move Item in this dialog; its table header cannot be dragged.

  4. To hide the row numbers, select ID in Column order and click the left arrow (Hide the selected columns). To bring it back, select it in Available columns and click the right arrow (Show the selected columns). The double arrows show or hide all the other columns at once. Item always stays shown, including when you hide all columns.

  5. Click Save to keep the changes to every table view you edited in this dialog. Other views keep their own order and hidden columns.

The columns up to and including Item stay in place when you scroll sideways, provided they take up no more than half the window. If that block is wider, only the row menus, row handles and selection checkboxes stay pinned. Hiding ID leaves those controls in place, and subtasks still open from Item.

Decide who opens it

The board's permission sets decide what someone may see and edit. A view then decides which of those columns and task groups it shows.

  1. In the same dialog, on Access, choose which permission sets can open the view. People who are not in any permission set see every view.

  2. On Landing, choose which permission sets start on this view when they open the board. A set can land only on a view it can open.

  3. Click Save. Columns, task groups, the summary-row choice, access and landing are saved together.

Give the client access to their tasks explains how to set up permission sets for clients and the other side.

Tips from practice

  • Hiding a column is not keeping it confidential. Columns belong to the board; hiding one in a view only tidies that view. What a client or the other side must not see belongs in their permission set.
  • Land people where they work. Give the client's permission set a landing view with their own items, so they do not start on the full checklist.
  • Duplicate, then trim. Build one view properly, then use Duplicate current view for the next workstream and change only its task groups.
  • Deleting a view asks you to type DELETE. Deleting a Signing or Binder view also removes its signing columns or binder set-up, so check before you remove one.

See also: choose what to track on each task and assign and follow up the work.
